Interconnected Solar Hybrid Mini-GridDelivered

Toto Interconnected Solar Hybrid Mini-Grid Rehabilitation & Integration

Technical supervision role on an interconnected solar hybrid mini-grid rehabilitation project involving solar PV generation, battery storage integration, transformer installation and restoration of an existing dormant distribution network. The project restored reliable electricity supply to the Toto community after approximately ten years of network inactivity.

Toto Interconnected Solar Hybrid Mini-Grid Rehabilitation & Integration project visual

Project image

Location

Toto, Nasarawa State, Nigeria

Period

Jul 2022 - Dec 2022

01 / Scope of Work

Work modelled, designed or delivered.

  1. 01

    Supervise generation-site construction activities including site marking, fencing layout, PV plinth preparation, civil work monitoring and PV structure installation.

  2. 02

    Coordinate installation of 952 PV modules, eight 50 kW PV inverters, PVDB, LVSG and SCADA communication infrastructure.

  3. 03

    Support integration of 972 kWh BESS system with associated power conversion, communication and energy management systems.

  4. 04

    Supervise installation of 1 MVA step-up transformer for grid interface and 500 kVA step-down transformer for system utilisation.

  5. 05

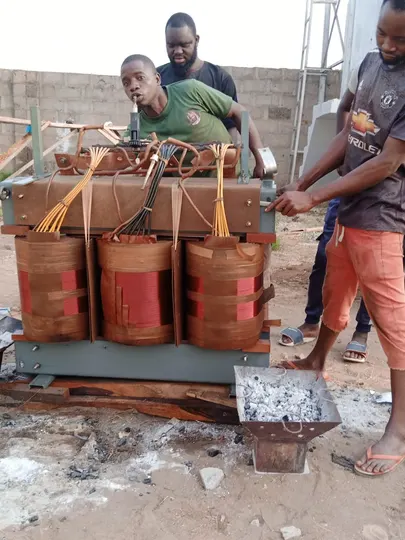

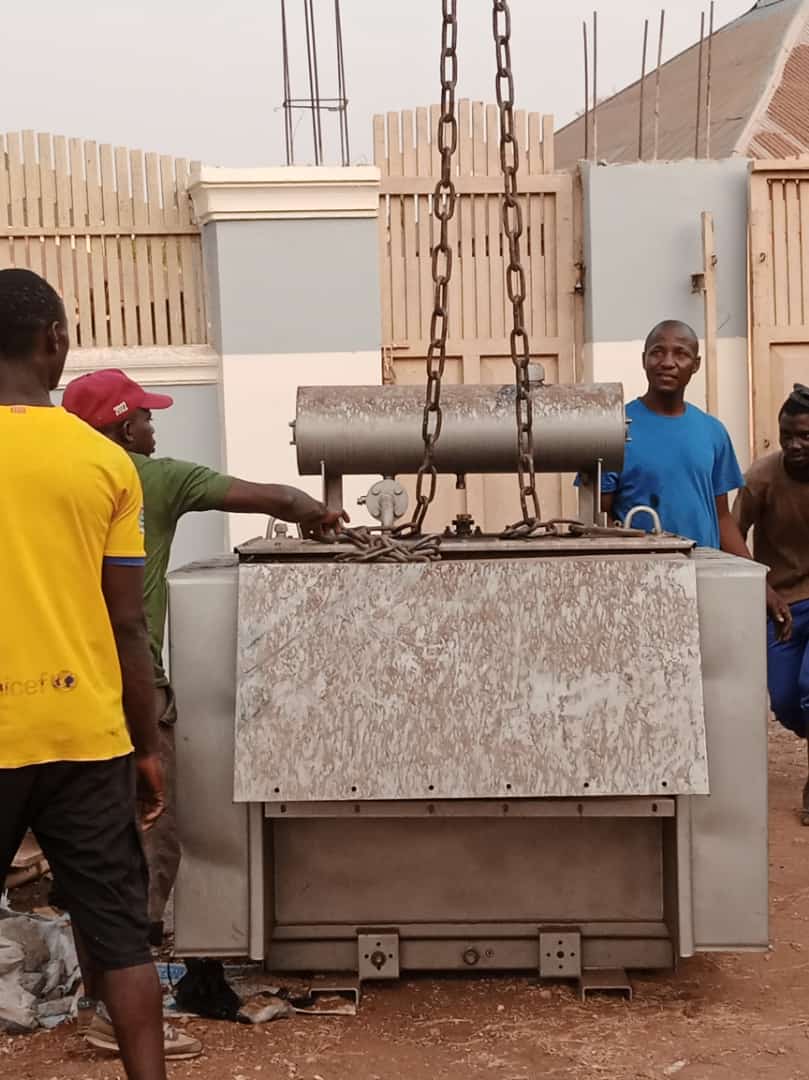

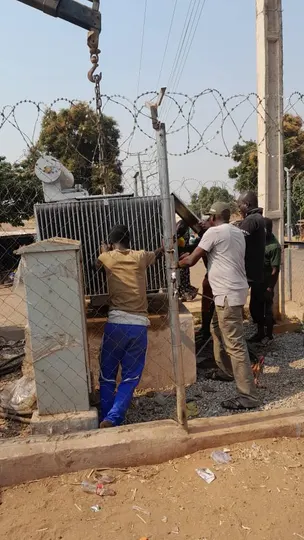

    Coordinate transformer rehabilitation activities across five existing community transformers including inspection, servicing, moisture removal and restoration activities.

  6. 06

    Supervise installation of transformer accessories including lightning arresters, gang isolators, earthing systems and associated protection equipment.

  7. 07

    Monitor installation of armoured cables, DC cables, cable termination, cable management and industrial earthing systems.

  8. 08

    Supervise contractor activities, quality inspections, electrical testing and technical documentation for project handover.

  9. 09

    Support integration of solar PV, BESS and existing distribution infrastructure to restore reliable electricity supply to the community.

02 / Results & Findings

Results from the project work.

  1. 01

    Successfully restored electricity supply to a previously dormant community distribution network after approximately ten years of inactivity.

  2. 02

    Supported reliable electricity access for over 2,800 households, commercial users, productive users and public facilities.

  3. 03

    Integrated solar PV generation, battery storage, transformers and existing distribution assets into an interconnected hybrid system.

  4. 04

    Improved network reliability through rehabilitation of existing transformer assets and installation of protection accessories.

    Field result

Project Evidence

Supporting project records.

Available for Toto Interconnected Solar Hybrid Mini-Grid Rehabilitation & Integration: Project Photos. Open an image for a closer view or select a document to read it.

01

Project Photos

6 items

More Case Studies

Compare this study with the other mini-grid, distribution and power-system projects.
